|
Setting up Schedule Templates for a 28-Day (4-Week) Shift Rotation
This topic describes the types of templates you will need to create, and the basic settings to use on each type of template. For more information on setting schedule template properties, see Setting Schedule Template Properties.Prerequisites
•To Create a 28-Day Rotation Hierarchy

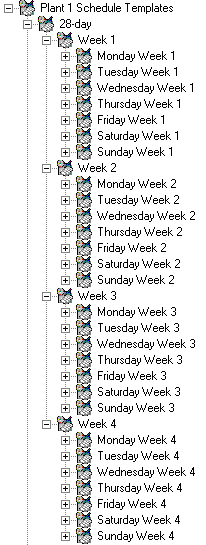

Create the Top Schedule Template
Hierarchy tab:
•General tab, Details tab:
• Schedules starts on: Monday
• Schedules duration is: 28 days
• Schedule title starts with: Start Date
• Followed by: Schedule Template NameGeneral tab, Maintenance Groups tab:
• Maintenance Groups: Select each of the four teamsGeneral tab, Shifts tab:
• Shifts: Select both shiftsAvailability tab:
• Sum the availability from the schedule's child schedules option is selected.Create the Weekly Schedule Templates
Hierarchy tab:
•General tab, Details tab:
• Schedules starts on: Monday
• Schedules duration is: 7 days
• Schedule title starts with: Start Date
• Followed by: Schedule Template NameGeneral tab, Options tab, Options tab:
General tab, Maintenance Groups tab:
• Maintenance Groups: Select all four teamsGeneral tab, Shifts tab:
• Shifts: Select both shiftsAvailability tab:

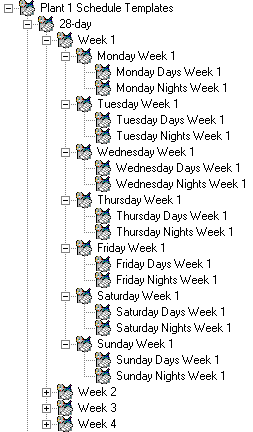

• Sum the availability from the schedule's child schedules option is selected.Create the Daily Schedule Templates
Hierarchy tab:
•General tab, Details tab:
• Schedule starts on: whatever day the template represents (that is, Monday for “Monday Week 1,” Tuesday for “Tuesday Week 1” etc.)
• Schedules duration is: 1 day
• Schedule title starts with: Start Date
• Followed by: Schedule Template NameGeneral tab, Options tab, Options tab:
•General tab, Maintenance Groups tab:
• Maintenance Groups: Select all four teamsGeneral tab, Shifts tab:
• Shifts: Select both shiftsAvailability tab:
• Sum the availability from the schedule's child schedules option is selected.
4. Repeat step 3 for the Week 2, Week 3, and Week 4 templates, making the appropriate changes to the names.Tip: You can quickly create the daily templates for each week by making copies of the Week 1 daily templates and then renaming them (schedule templates must all have unique names). You will also need to move the copies to the correct location in the schedule template hierarchy. You can do this from the General tab of any template.Create the Shift Schedule Templates
Hierarchy tab:
•General tab, Details tab:
• Schedule starts on: whatever day the template represents (that is, Monday for “Monday Days Week 1,” Tuesday for “Tuesday Days Week 1” etc.)
• Schedules duration is: 12 hours
• Schedule title starts with: Start Date
• Followed by: Maintenance Groups
• Followed by: ShiftsGeneral tab, Options tab, Options tab:
•General tab, Maintenance Groups tab:

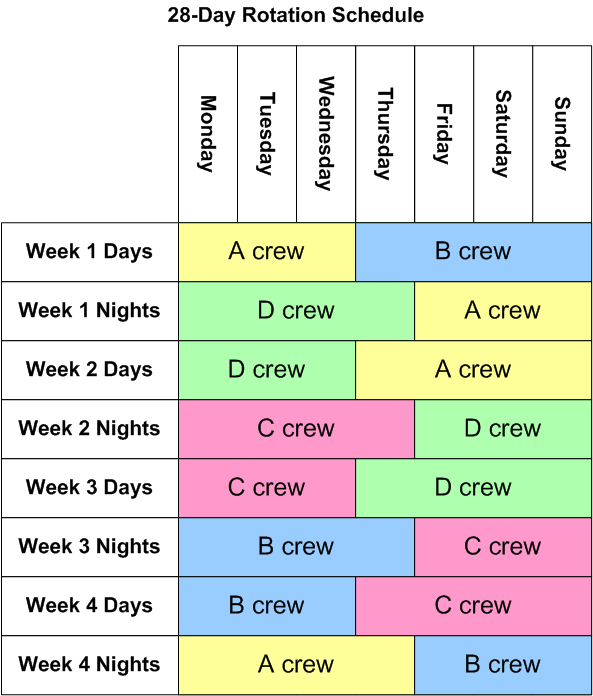

• Maintenance Groups: Select ONLY the team that will be working that shift on that day (Team A, B, C or D). For example, if you look at the diagram of the shift rotation at the beginning of this topic, you will see that A-Team is working the day shift from Monday to Wednesday, and B - Team is working the day shift from Thursday to Sunday.General tab, Shifts tab:
• Shifts: Select the “12-hour Days” shift.Availability tab:
•
6. Repeat step 5 for the week 1 night shifts. All of the settings will be the same, except for:Details tab:
• Maintenance Groups: Select ONLY the crew that will be working the night shift on that day (Team A, B, C or D). For example, if you look at the diagram of the shift rotation at the beginning of this topic, you will see that D-Team is working the night shift from Monday to Thursday, and A-Team is working the night shift from Friday to Sunday.
• Shifts: Select the “12-hour Nights” shift.
7. Repeat steps 5 and 6 for the Week 2, Week 3, and Week 4 templates, making the appropriate changes to the names and maintenance group selections.Test the Schedule Template Hierarchy
•

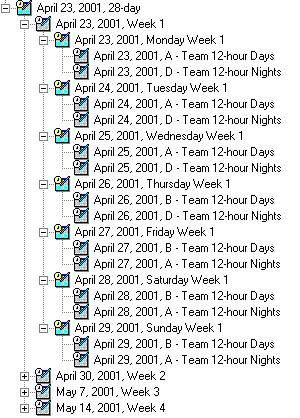

• The system creates a schedule for each template in the hierarchy. This will take several minutes to complete. When the generation of schedules is finished, APM opens the top schedule.
