Performing Risk Analysis for RBI Failure Modes

In the process of evaluating a failure mode, you can quantify the relative risk (criticality) associated with the failure by evaluating the consequences (severity of the effect) and the probability of the failure occurring, assigning values for each factor. APM then calculates the relative risk by multiplying the severity number by the probability value.
When the relative risk is established, APM calculates the failure mode’s priority using a set of customer-defined rules. The consequence priority rules can be based on the failure mode’s severity, relative risk, downtime costs, downtime duration, or a combination. For example, the Extreme priority could be assigned to failure modes whose total severity is equal to 5.0.
You can apply a confidence factor to the analysis to quantify your faith in current maintenance or inspection practices to contain the failure mode’s risk. The confidence factor can adjust the inspection factor or the failure mode’s position in the risk matrix.
After you have analyzed the failure modes, you can compare failure modes and identify the relative importance of addressing them. The Risk Assessment view in the Strategy Development Analysis window includes failure mode lists based on criticality, consequence priority, severity, and relative risk, as well as a risk plot, risk matrix, and lists of the evaluations. This view is also available for the asset.
RBI analyses, typically for assets with Oil and Gas specifications, can use lookup tables and calculations to determine a failure mode’s probability of failure or consequence severity. For example, a health and safety evaluation could calculate the failure mode’s consequence ranking based on the toxicity index value assigned to the asset’s fluid type. For information about using these questionnaires, see Setting up Consequence Severity Evaluations to use Lookup Tables.
APM provides two ways to perform risk analysis:
With both methods, APM calculates the relative risk and displays it in the risk matrix chart. The method available in the Maintenance Action Plan window depends on the option selected in risk analysis settings.
For instructions on using the simpler evaluation with weighted severities, see Performing RBI Risk Analysis with Weighted Severities.
Note: APM also provides a method of performing risk analysis on safety devices that protect equipment, people, and environments from events such as pressure build-up, fire, or equipment failure. Risk analysis is performed on one or more demand scenarios identified on the failure mode. For more information, see Performing RBI Demand Scenario Risk Analysis.
Note: Before you can perform risk analysis, the severities, probabilities, confidence factors, and risk matrix entries must be set up in the site’s risk analysis settings. If you are using evaluation forms, they must also be set up. For more information, see Setting up APM for RBI Analysis.
This topic explains how:
1.
To Evaluate the Probability of Failure – The probability of failure is the likelihood that the asset will fail due to the failure mode. You can determine the probability score using a questionnaire, selecting a value directly, or entering the estimated time between failure (ETBF). The options available to you depend on the analysis’ risk settings.
2.
To Evaluate Economic Effects of Failure – The economic consequence of failure reflects the financial effect of the failure on assets and production. Labor and material costs associated with lost production and with repairing or replacing the damaged equipment are economic consequences. The options available to you depend on the risk analysis settings. You can use a questionnaire or select a value directly, depending on the analysis’ risk settings.
3.
To Evaluate Health and Safety, Environmental, and Reputation Consequences – Equipment failure can cause hazards in the workplace and environmental damage. Examples are extreme temperatures, noxious fumes, and the release of liquids that cause pollution. Mitigating factors are considered when assessing health and safety and environmental consequences. Reputation consequences measure the impact that negative media attention has on an organization’s ability to operate in good faith. The levels of severity can also be associated with monetary costs. You can use questionnaires or select values directly, depending on the analysis’ risk settings.

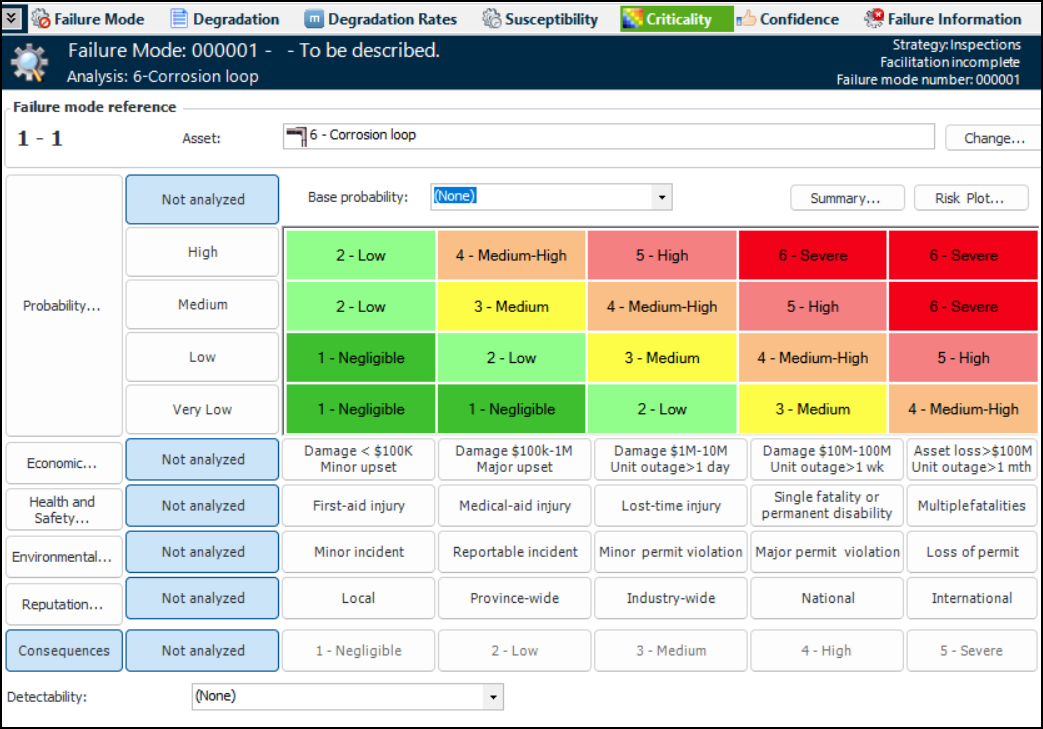

When you have finished the probability and consequence evaluations, the risk matrix shows the resulting criticality and consequence scores. In this example, the results are Medium High (criticality) and Medium (consequences):
4.
To Assign a Detectability Value – When support for detectability is enabled in an analysis, the relative risk calculation becomes:
(Economic severity score + Health and safety severity score + Environmental severity score + Reputation severity score) * Probability score * Detectability score = Relative Risk Number
5.
To Evaluate Confidence Factors – The confidence rating reflects the confidence that the inspector and materials or corrosion engineer have in current maintenance or inspection practices to contain the failure mode’s risk. The higher the value, the greater their confidence. The failure mode’s criticality rating, mediated by the confidence factor, results in an inspection factor, interval, strategy, or a combination.
6.
Viewing the Risk Analysis Summary – You can view the most recent evaluation results by clicking Summary on the Criticality tab. The Risk Summary dialog displays tabs for each of the questionnaires used in the analysis.
Tip: You can export criticality evaluations for all the analysis’ failure modes to a Microsoft Excel® file. Then add data to the file and import it back into the analysis. For more information, see ......

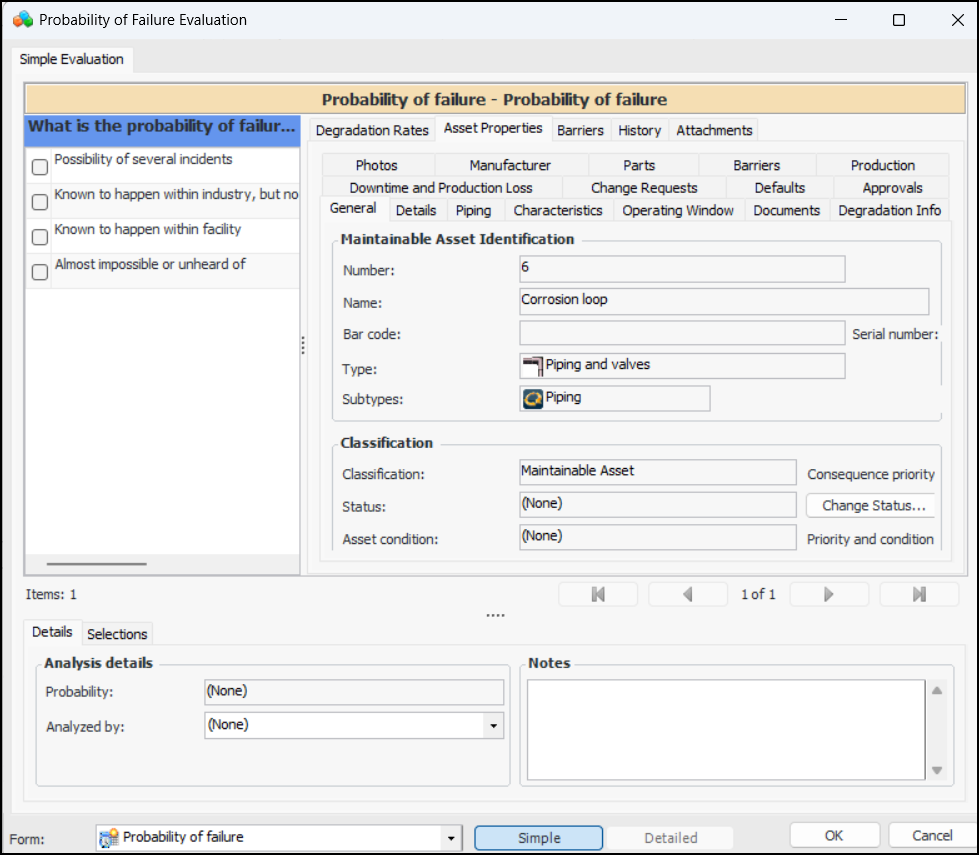

To Evaluate the Probability of Failure

1.
2.
3.
Select the Criticality view. For example:
4.
Enter the amount of time and the unit of measure. The corresponding probability value is selected in the risk matrix.
5.
To use a questionnaire, click Probability. The Probability of Failure Evaluation appears. The evaluation types (Simple, Detailed), categories, and questions available to you depend on the form’s design and the asset properties. Here is an example of a simple evaluation:
You can refer to the History and Barriers tabs for information to aid in the evaluation, for example, historical inspections, failures, and work.
6.
As you move through the analysis, the Probability box displays the most severe probability value assigned to your selections. For example, if you select options for three categories, two of which have a result of “Negligible” and one with a result of “High”, the score for the evaluation as a whole will be “High”. This will be the probability used in the risk analysis.
7.
In the Analyzed by list, select the team member performing the evaluation.
8.
In the Notes box, you can provide additional information about the analysis. Notes are collected and available in several locations.
9.
When you have completed the evaluation, click OK. The evaluation form closes and the result (for example, very high, high, medium, low, or negligible) is selected in the risk matrix. For example:

To Evaluate Economic Effects of Failure

1.
In the risk matrix, click Economic. The Economic Effects Evaluation form appears. For example:
At any time, you can refer to the Asset Properties, History, Barriers, and Attachments tabs for detailed information about the asset.
2.
As you enter amounts in the Total cost of lost production, Total repair costs, and Total labor costs boxes, APM calculates the total amount and the severity.
3.
To perform a more detailed evaluation, click Detailed. Here is an example of a detailed form:
As information is added to the form, APM calculates the total costs for the failure and displays the Severity score. All monetary amounts are shown in the site’s currency.
4.
Tip: Select the Asset Properties tab and then the Downtime and Production Loss tab to view the production loss cost equation.
5.
6.
Select the Labor and Miscellaneous tab. For example:
7.
Enter information to calculate labor costs. The number and types of trades listed in the Labor costs area are defined in the Economic Evaluations settings. They vary depending on the trades defined for the site and selected for the evaluation. For each trade, enter the amount of time required to respond to the failure. APM calculates the cost based on the trade’s rate.
8.
Secondary damage is additional damage caused to other assets by the initial or primary failure. If appropriate, select Secondary damage costs and enter an amount and a description of the damage. This information is included in the total costs and shown on the failure mode’s Failure Data tab.
9.
In the Occurrence costs box, enter the estimated fixed cost associated with a downtime occurrence. For example, this could be a fixed cost associated with restarting a machine after it has been shut down.
When failure mode optimization requires Isograph Availability Workbench, this attribute is mapped to project effect per occurrence cost in AWB.
10.
In the Cost of multiple failures box, enter the estimated cost if a protected function fails while its protective device or protective system is in a failed state.
11.
In the Notes box, you can enter additional information about the evaluation. Notes are collected and available in several locations.
12.
Select the Details tab. In the Analyzed by list, select the team member who performed the evaluation.
Note: For information about creating production cost rules, see Setting up Production Loss Rules on an Asset.
13.
When you have finished the evaluation, click OK. The result of the economic evaluation is shown in the risk matrix. For example:

To Evaluate Health and Safety, Environmental, and Reputation Consequences

1.
Click Health and Safety, Environmental, and Reputation in turn. The evaluation form appears. The evaluation types (simple, detailed), categories, and questions available to you depend on the form’s design and the asset properties.
At any time, you can refer to the Asset Properties tab for detailed information about the asset.
2.
As you move through the analysis, the Severity box displays the most severe score assigned to your selections. For example, if you select options for three categories, two of which have a result of “Negligible” and one with a result of “High”, the score for the evaluation as a whole will be “High”. However, if a mitigation category has been defined for the evaluation, its score can raise or lower the severity. The resulting ranking is used in the risk matrix.
3.
In the Analyzed by list, select the team member performing the evaluation.
4.
In the Note box, you can provide additional information about the analysis. Notes are collected and available in several locations.
5.
When you have completed an evaluation, click OK. The evaluation form closes and the result is selected in the risk matrix. For example:

To Assign a Detectability Value

1.
In the Criticality view, select the appropriate value from the Detectability list below the risk matrix. This number is used in the relative risk calculation.

To Evaluate Confidence Factors

1.

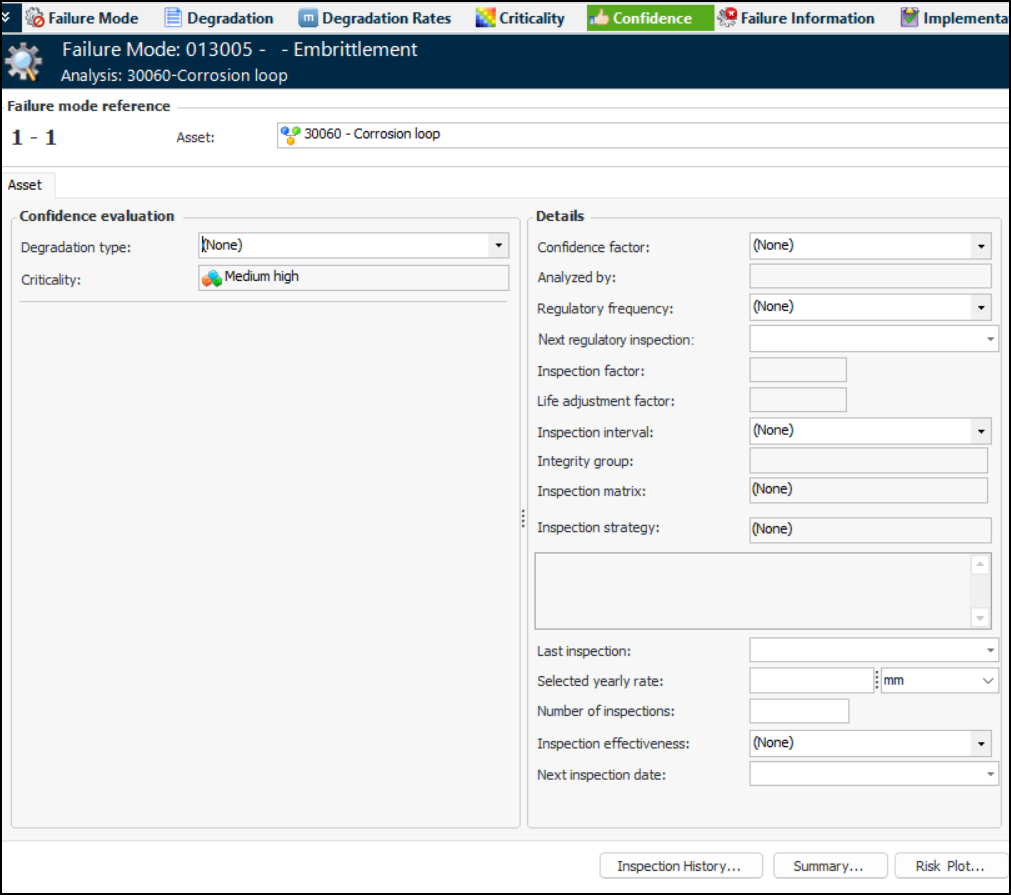

Select the Confidence view. For example:
The Criticality box shows the result of the evaluations you performed on the Criticality view. If the degradation type has been identified in the failure mode’s degradation details, it is selected here.
Note: Degradation types, their confidence statements, and the scores assigned to them are set up in confidence settings and will vary depending on your organization’s requirements.
2.

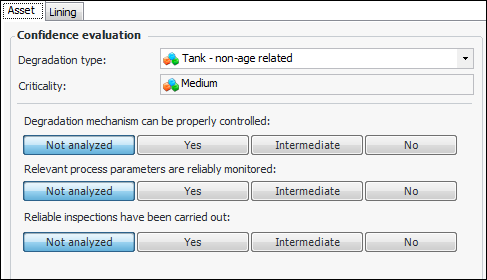

In the Confidence evaluation area, select a degradation type. One of the following occurs:
The Confidence factor box displays the default for the degradation type. If the degradation type’s settings allow, you can select another value from the Confidence factor list.
For each confidence statement, click a response, for example, No, Yes, or Intermediate. The Confidence factor box displays the result of your selection, indicating if confidence is low or high. The inspection factor, inspection interval, integrity group, and inspection strategy might also be supplied.
3.

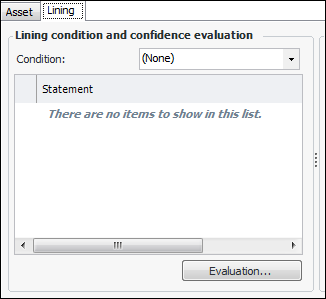

The Lining tab is available if the asset has lining properties and the degradation type requires a separate confidence evaluation. Select the Lining tab. You will see one or more of the following:
The Condition list is available. Select a value from the list to describe the state of the lining at the time of inspection.
Confidence statements are presented as they are on the Asset tab. Select the appropriate responses.
Note: If both the Condition list and either confidence statements or an evaluation are available, the lesser of the two results determines the life adjustment factor shown in the Details area.
The Evaluation button is available. For example:
Click Evaluation to open the Confidence Evaluation window. For example:
Select a statement and click OK. The form closes and the statement is shown in the Lining tab. The Details area displays the inspection factor, inspection interval, or both, depending on the evaluation form’s properties.
4.
In the Details area, add the regulatory inspection frequency and the last inspection date. APM calculates the next regulatory inspection date, which you can change if required.
Note: If you selected a degradation rate on the Degradation Rates tab, as explained in Adding Degradation Rates to RBI Failure Modes, the selected yearly rate and next inspection date are copied to the Details area. Otherwise, you can enter these values here.

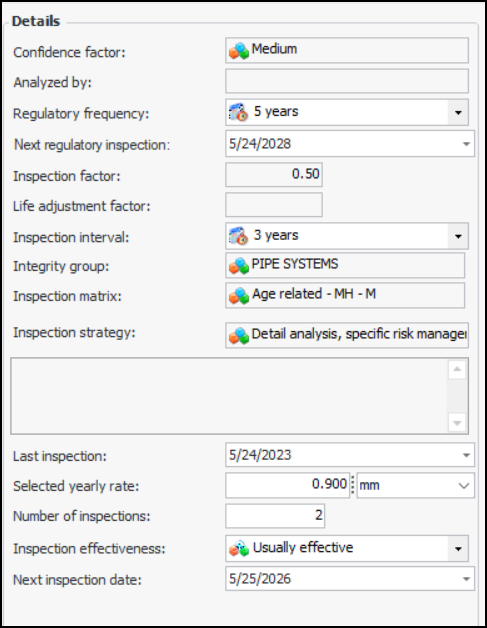

In this example, the confidence evaluations resulted in an inspection factor of 0.50, as shown in the Details area:
The information in this area includes:
Note: When the failure mode is marked Facilitation or Implementation Complete (or the study is promoted) its indicator can be updated with the life adjustment factor. If the indicator’s degradation rate supports lining, APM surveys the indicator on all of the failure modes where it is used. The shortest (non-zero) life adjustment factor is copied to the degradation rate’s Life Adjustment Factor setting. The analysis’ failure mode settings must specify that existing indicators use the values from the action plan.
Note: If the failure mode is based on an entry in the Damage Mechanism Library, the entry’s settings might specify that only one of inspection factor, inspection interval, or inspection strategy is permitted for the failure mode.

Viewing the Risk Analysis Summary

1.
In the Criticality view, click Summary to display the results of the risk analysis. For example:
A tab is displayed for the confidence evaluation and each of the questionnaires that were used to evaluation probability of failure and consequence severities.
2.
3.
Click Close to dismiss the window.
