|
Acknowledging Indicator Alarms with AWEIS
Tip: After creating an acknowledgment, you can view information about it in the site’s Inspection Management view, Readings tab, Acknowledgments tab. This tab lists the acknowledgments by date and includes columns for asset, indicator, reading date, indicator state, acknowledgment method, and status. Double-click an acknowledgment to open its dialog.Follow-up Readings
Failure Tracking
Escalation and Automatic Acknowledgment of Alarms
Most Recent Reading or Most Severe Unacknowledged Alarm
Solution Packages
Events or Failure Codes
The Failure code type setting in the site interoperability profile determines whether events or failure codes are available in the request for work. If it is set to Object part, damage and activity codes, the Events tab appears in the Acknowledge Indicator Alarm window.If Failure codes is selected in the site interoperability profile, the Failure Codes tab appears in the Acknowledge Indicator Alarm window. You can select as many as five failure codes from those defined for your organization and enter a description.Note: To use failure codes in APM, you must first enable feature 46. In the Enterprise window, select the Features view and the Enabled Features tab. Click Browse, select “Failure codes support with AssetWise Interoperability”, and click OK. If APM is running as a smart client, click Refresh Enabled Features. Then restart the client to use the functionality.Breakdown Information
Recommended Tasks
Labor Requirements
Work Document Characteristics
The reference numbers that you enter on the References tab can appear in the Characteristics tab when the request has been submitted. When the external CMMS is SAP, the reference numbers are added to the notification. To prepare for creating requests for work, be sure to set up classification classes and map sets for work documents.To Start the Acknowledgment
1. Locate the indicator in the site’s or asset’s Inspection Management view. Select the Indicators tab, By Asset Hierarchy tab. In the list of configurations, select “Indicators currently in alarm”. The indicator’s warning or alarm state is signaled with a flashing icon.
• Indicator window – Select the Readings view and tab. Select the reading in the table and click Acknowledge Alarm
• Indicator Reading or Measurement Point Reading dialog – Select the Acknowledgment tab and click Acknowledge
• Inspection Report window – Select the Inspection Report view, Readings tab. Select the reading in the table and click Acknowledge

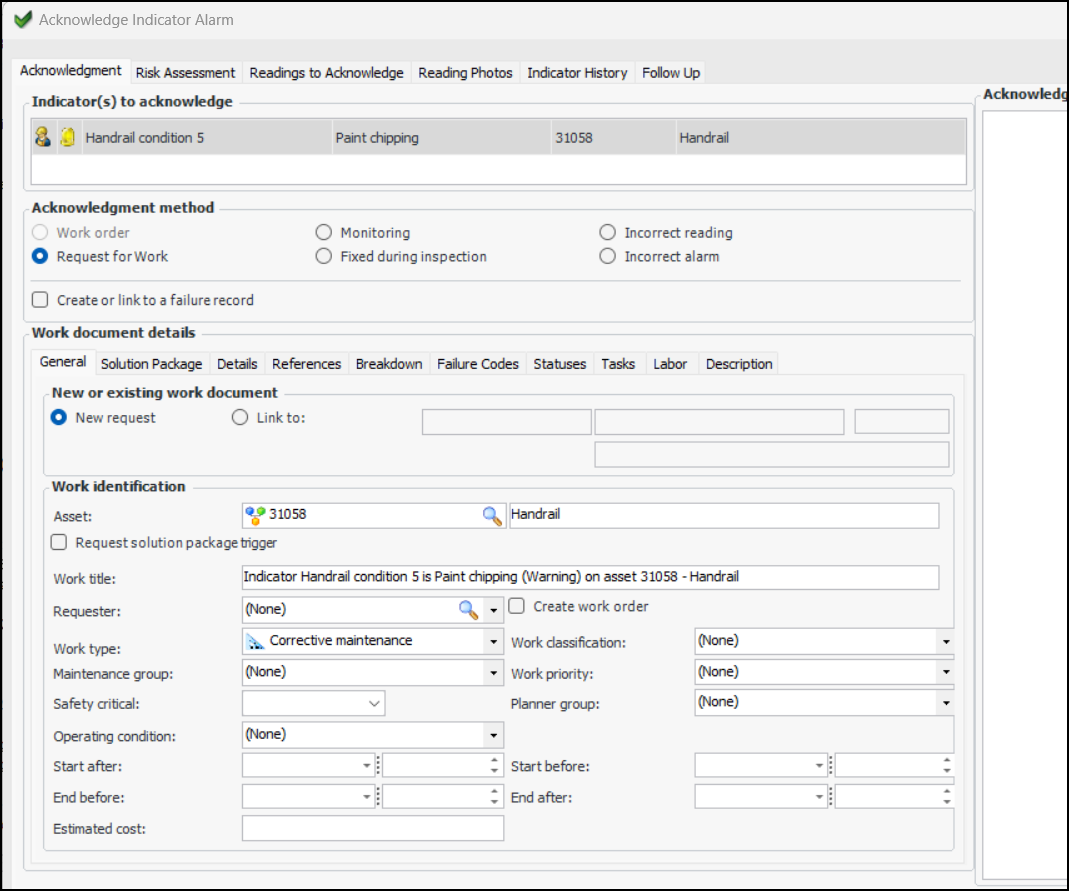

2. Right-click the indicator and click Acknowledge Alarm. The Acknowledge Indicator Alarm dialog appears. For example:
3. The Indicator(s) to acknowledge table lists the alarm to be acknowledged. If your site uses the most “severe unacknowledged alarm” policy, the most severe alarm is shown in this table. Select the Readings to Acknowledge tab to view all unacknowledged alarms for the indicator. By default, all of the alarms are selected.Tip: You can acknowledge an alarm individually by selecting it, returning to the Acknowledgment tab and continuing with the following steps. The alarms that you did not acknowledge remain in affect until they are acknowledged.
• Request for Work: Create or link to an existing request for work
• Monitoring: Indicates that the indicator will be monitored
• Fixed during inspection: Stating that the problem that caused the alarm was fixed during inspection
• Incorrect reading: Stating that the indicator reading was incorrect
• Incorrect alarm: Stating that the alarm settings were incorrect and an inappropriate alarm was triggered
5. The site’s indicator settings (acknowledgment policies) can specify that the default behavior is to create a failure when an alarm is acknowledged with the selected method. In this case, Create or link to a failure and anomaly is selected and the Failure tab appears in the Acknowledge Indicator Alarm dialog. If this option is not selected, you can click it to show the Failure tab and link the acknowledgment to a new or existing failure record. For more information, see Creating a Failure to Acknowledge an Alarm with AWEIS.
6. By default, a new request for work will be added when the acknowledgment is processed. To reference an existing work document instead, click Link to, select the type of interop work document, and select the open document. Skip to To Request a Follow-up Reading.Note: To acknowledge an alarm with an existing work document, you must first enable feature 49. In the Enterprise window, select the Features view and the Enabled Features tab. Click Browse, select “Ability to link an acknowledgment to an existing work document with AssetWise Interoperability”, and click OK. If APM is running as a smart client, click Refresh Enabled Features on the server. Then restart the client to use the functionality.
7. On the General tab, the indicator asset is selected by default. You can browse for another asset, if appropriate. The asset must be (or be descended from) an interop asset, which means that there is a corresponding object in the CMMS. The asset can be the descendant of an interop asset in the site’s physical hierarchy.To Add Work Information
2. Select start and end dates as appropriate. If the End before date is displayed, it is calculated using the request’s creation date plus the duration of the work priority’s “work to be completed within” setting.To Add a Solution Package

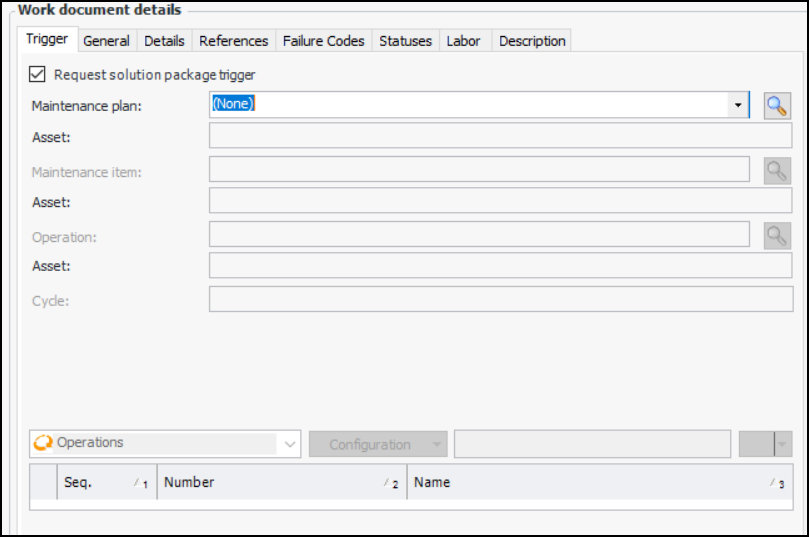

1. If you wish to trigger the solution package following the successful submission of the request for work, select Request solution package trigger on the General tab. The Trigger tab is added and the Solution Package, Statuses, Tasks, Labor, Description tabs are removed from the window.
2. If you do not wish to trigger the solution package, select the Solution Package tab and select the solution package level(s) and cycle, as needed.To Enter Values for User Fields and Reference Numbers
1. If your organization has defined user fields, the Details tab is available, where you can select the appropriate strings, dates, and options.

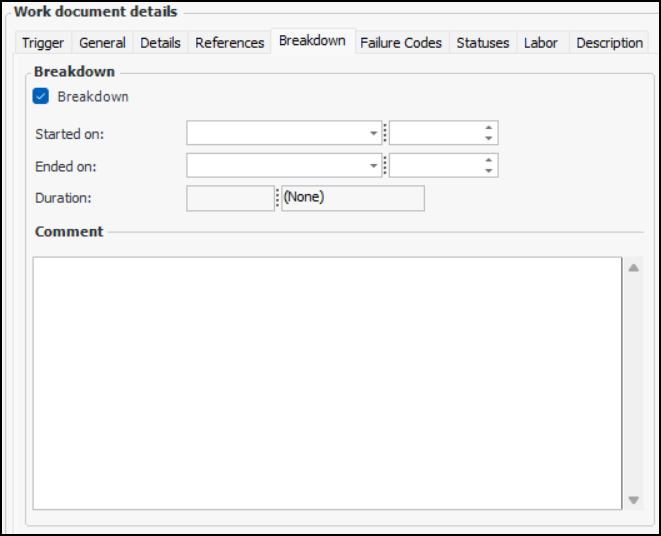

2. If your organization has defined reference numbers, select the References tab to enter values. The tab can contain up to five text boxes where you can enter numbers specific to this request and your organization’s requirements.To Enter Breakdown Information
1.To Select Failure Codes

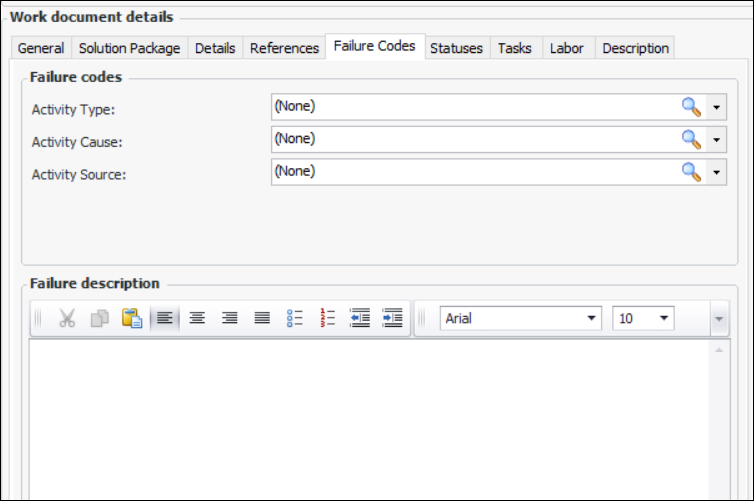

1. If the site interoperability profile specifies failure codes, the Failure Codes tab appears in the window. This tab lists the failure codes that have been defined for your organization. For example:To Add Events

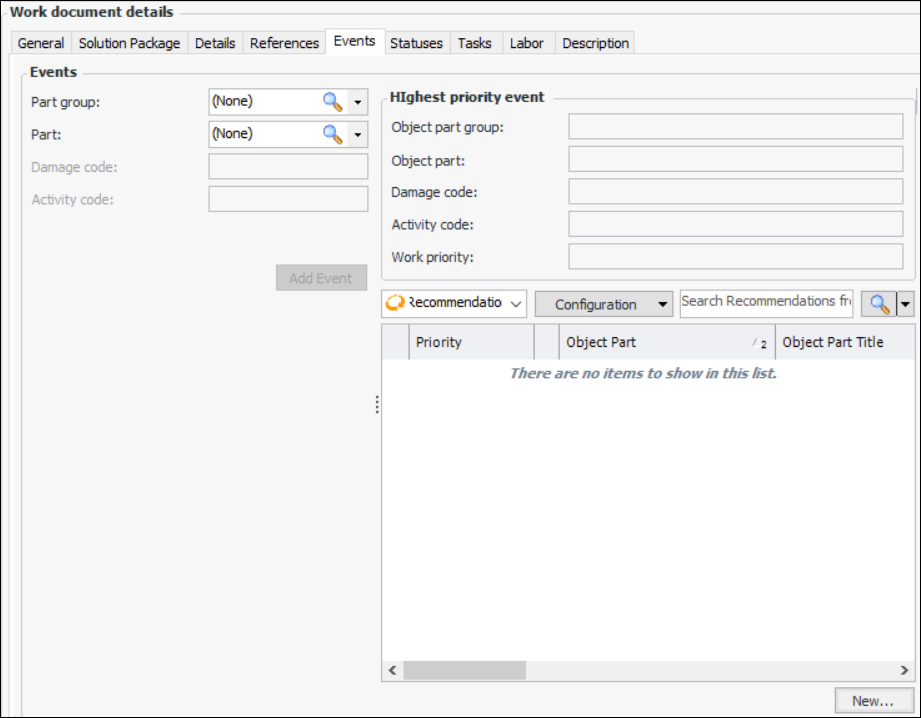

1. If the site interoperability profile specifies object part, damage code, and activity code, the Events tab appears in the window. For example:
3. When you have selected the codes, click Add Event. APM adds the event to the “Recommendations from event” table and calculates the highest priority event.Tip: You can open the Event Properties dialog for an event by double-clicking it in the table. You can also click New to create an event. For example:To Select Secondary Statuses

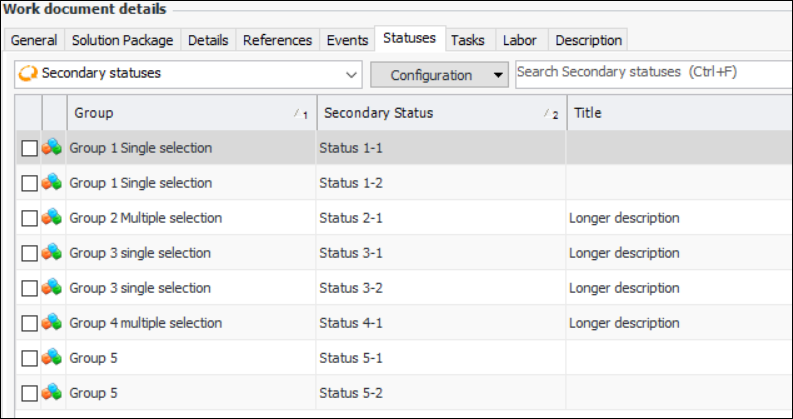

1. Select the Statuses tab. For example:To Add Tasks and Labor Requirements
1. Select the Recommended Tasks tab to add one or more recommended work steps to the request. Click New. The Recommended Task Properties dialog appears:

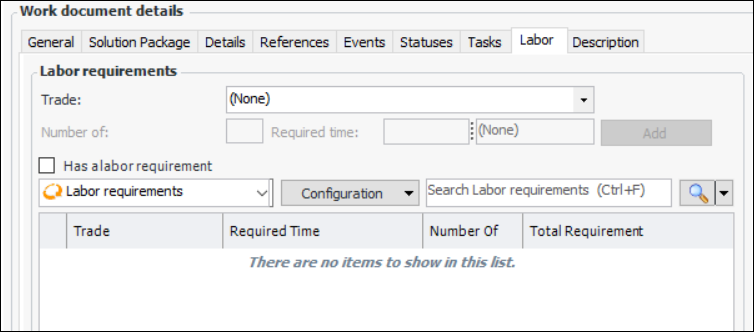

3. To record labor requirements, select the Labor tab.
7. Click Add. The requirement is added to the table.Tip: You can edit a labor requirement by double-clicking it in the table to open its dialog. Click Edit and make your changes. Click OK when you have finished.To Request a Follow-up Reading
1. If you wish to request a follow-up reading, select the Follow Up tab and select Schedule a follow-up reading.Select a time period from the Follow up reading is required in list. The indicator’s collection due date changes to the date of the acknowledgment plus the follow-up time.Tip: To view the next collection due date in the Indicator window, select the Readings view and the Next Reading tab.To Complete the Acknowledgment
1. Enter your notes in the Acknowledgment comments box.
2. Click OK. APM closes the dialog, creates the required objects, and turns off the warning or alarm on the indicator.Tip: The request for work is listed in the Indicator Reading and Acknowledgment windows, as well as in the asset’s and site’s Work Management view.
3. Open the Request for Work Properties window to review it. You can select the Source tab to view the acknowledgment and indicator reading.Tip: You can click Submit from the Request for Work Properties dialog to release the document to AWEIS. Or you can select one or more requests in the Requests for Work tab and click Submit.When the request has been submitted, you can return to the Request for Work Properties dialog and select the Characteristics tab. Information about the request is displayed in the Source and History tabs. Select the Work tab to view the linked interop work request or interop work order.
